Time tracking
Log hours against tasks. Set an estimate, compare actual vs. planned, and see totals in the table view’s time column.
![]()

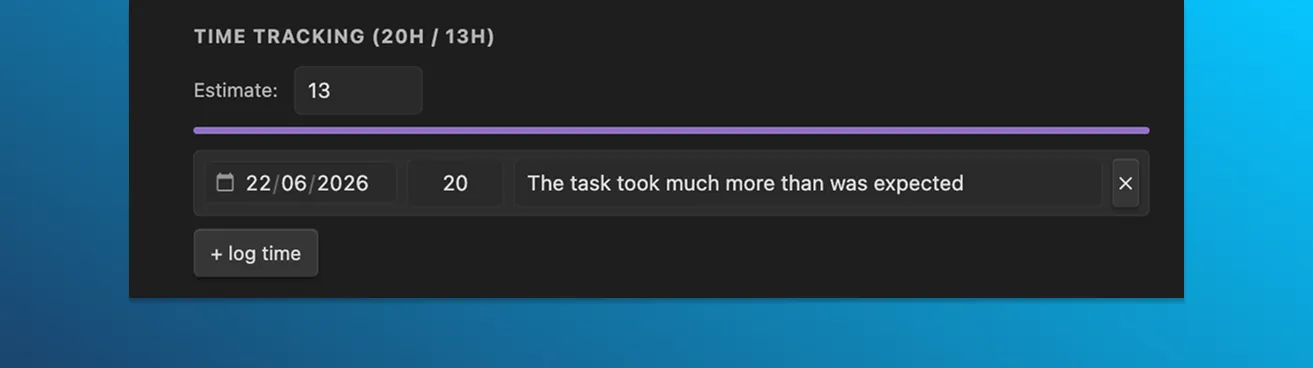

The time tracking panel
Open any task. The time tracking panel sits below the standard fields. The panel is hidden for milestone-type tasks (which don’t have duration).
The panel header shows totals — Time tracking (2h / 10h) means 2 hours logged against a 10-hour estimate.
Set an estimate
In the panel, set estimate (hours). Step is 0.5 hours; minimum 0.
If an estimate is set, a progress bar shows logged ÷ estimate. The bar turns red if you exceed the estimate.
The estimate is optional — leave it at 0 (or unset) and the bar is hidden.
Log time manually
Each log entry has three fields:
- Date (
YYYY-MM-DD, defaults to today). - Hours (number, step 0.25, min 0).
- Note (free-form text).
Click + log time to add an entry. Each entry has a remove button on its right.
Logs save with the task — on Save, or on close if save tasks on close is on.
Where time data lives on disk
The task’s YAML includes a timeLogs array, omitted if empty:
timeEstimate: 10
timeLogs:
- date: "2026-05-22"
hours: 1.5
note: "First draft"
- date: "2026-05-23"
hours: 0.5
note: "Edits after review"
Adding or editing entries by hand is fine — the plugin re-reads on file change.
Totals in the table view
The time column in the table view shows the sum of hours across the task’s timeLogs. It’s display-only; not currently sortable.
![]()
Where to go next
- Data format —
timeLogsandtimeEstimatein full. - Table view — the time column.
Tips
Logging is manual — there’s no auto-tracker. Trade-off: lower friction to set up, no background process, but you have to remember to log. Most people batch logs at the end of a session.
Big estimates (“80h”) tend to be wrong. If you find a task is heavily over its estimate, break it into subtasks with their own estimates. Rollups give you a more honest picture.
